Product Prioritization

By Janna Bastow

Updated: August 25th, 2026

Reviewed by: Simon Cast

Fact checked by: Julie Hammers

In most product organizations, the word “prioritization” covers at least four separate decisions happening in different rooms on different cadences. The exec team is choosing which product lines get headcount next year. The Head of Product is deciding which problems earn a place on the roadmap this quarter. A Product Manager is working out which of six ideas to test first. An Engineering lead is sequencing tickets for the next sprint. All of it gets called prioritization, and the shared word hides the fact that these decisions run on different evidence, different timeframes, and different people. Getting clear on what product prioritization actually refers to is the first step to doing it well.

What is product prioritization?

Product prioritization is the continuous practice of deciding which problems, ideas, and pieces of work a product team commits to next, and recording the reasoning behind each choice. It happens at portfolio, objective, problem, and idea level, and its real output is a decision the team can defend later.

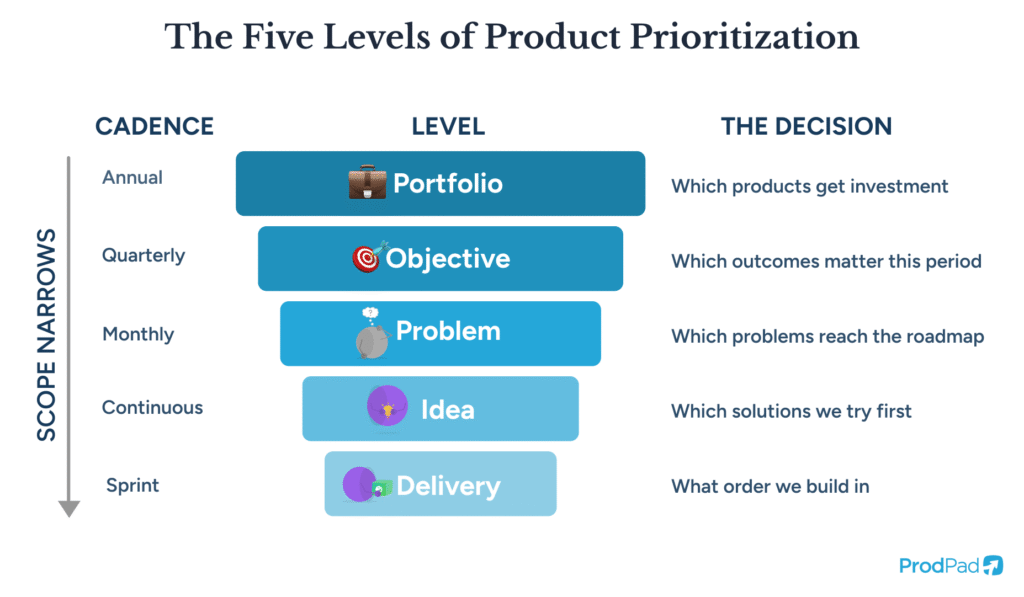

Diagram showing the five levels of product prioritization in ProdPad Product Management software

That definition does a lot of work, so it is worth unpacking. Most treatments of the subject describe product prioritization as sorting a list. Sorting is the visible part. The substance sits underneath it, in the reasoning that produced the order and the conditions under which the order should change.

Product prioritization is continuous because the evidence underneath it keeps moving. A customer segment churns, a competitor ships, an experiment comes back flat, a regulatory deadline lands, and the ranking that made sense in January stops making sense in March. Teams that treat prioritization as a quarterly event end up defending a plan built on stale information. Teams that treat it as an ongoing practice revisit decisions when the inputs change and leave them alone when they do not.

The other thing worth naming early is what a good product prioritization decision produces. It is a record: what the team chose, what it declined, what evidence supported the call, who made it, and what would need to be true for the answer to change. Without that record, every stakeholder who missed the meeting has standing to reopen it, and the same debate cycles through the organization every few weeks. The product backlog becomes a graveyard of arguments nobody remembers winning.

What are the levels of product prioritization?

The single largest source of confusion around product prioritization is altitude. Decisions at different levels draw on different evidence, involve different people, and move at different speeds. Ranking a security upgrade against a copy change is a category error, and it happens constantly because both items live in the same list. Separating the levels is what makes each decision tractable.

Portfolio level

At the top, product prioritization is a capital allocation question. Which products, product lines, or business units receive investment, and in what proportion. The evidence is commercial: revenue concentration, market position, margin, strategic optionality. The people involved are executives and product leadership. This decision typically moves annually or semi-annually, and it constrains everything below it. Product portfolio management is the discipline that governs this level.

Objective level

One step down, product prioritization means choosing which outcomes matter in a given period. A team cannot pursue reduced churn, faster onboarding, expanded enterprise coverage, and platform stability with equal intensity at the same time. Picking two and consciously deferring the rest is a prioritization decision, and it is usually expressed through OKRs or an equivalent goal structure. This is the level most organizations skip, which is why so many roadmaps read as a list of unrelated good ideas.

Problem level

Problem-level product prioritization decides which customer or business problems earn space on the roadmap. The unit here is an initiative: a problem to solve or an outcome to achieve, stated without presupposing the solution. The evidence is a mix of customer feedback volume and severity, usage data, commercial impact, and strategic fit. This is the level a Now-Next-Later roadmap is built to express, because it sorts by confidence and proximity rather than by date.

Idea level

Once a problem is on the roadmap, product prioritization narrows to solutions. Given a problem worth solving, which of the available approaches should the team try first, and in what sequence. The evidence shifts toward feasibility, expected impact, and the cost of learning. Most published prioritization frameworks operate here, which is why they feel unsatisfying when applied to the levels above.

Delivery level

At the bottom, product prioritization becomes sequencing. Given committed work, what order do we build in, accounting for dependencies, team capacity, and release windows. This decision belongs to the delivery team and lives in the delivery tool. Sprint planning and story points sit here.

The levels compound. A well-made objective decision reduces the number of problems worth arguing about. A well-made problem decision reduces the number of ideas that need scoring. Organizations that only prioritize at the idea level find themselves relitigating strategy through the back door, one feature request at a time.

See why prioritizing problems before ideas makes the decision easier

What is the difference between product prioritization and the practices around it?

Product prioritization is routinely confused with the activities that sit next to it in the workflow. The confusion is not academic. When a team believes it is prioritizing but is actually estimating, the resulting decisions inherit the wrong evidence and the wrong participants.

Product prioritization and estimation

Estimation answers how much something will cost in time or effort. Product prioritization answers whether the cost is worth paying relative to the alternatives. Effort is one input among several. Teams that collapse the two end up building whatever is cheapest, which is a reliable path to a feature factory. Basecamp’s Shape Up makes the distinction sharply with the concept of appetite: deciding upfront how much time a problem deserves, then designing a solution to fit, rather than designing first and discovering the cost afterward.

Product prioritization and backlog grooming

Backlog grooming is maintenance. It clarifies items, adds detail, merges duplicates, and archives things that will never happen. Product prioritization is the decision about what gets worked on. Grooming makes a backlog legible enough for prioritization to happen; it does not substitute for the decision.

Product prioritization and roadmapping

A roadmap communicates priorities. Product prioritization produces them. The two are tightly coupled, which is why roadmap format shapes prioritization behavior so strongly. A timeline roadmap requires a fixed order of delivery, which forces teams to manufacture false precision about work they have not validated. An outcome-based roadmap organized by confidence horizons lets priorities hold their shape while the details underneath keep changing. Roman Pichler makes a related argument for keeping the roadmap and the backlog as separate artifacts: once epics and user stories creep up onto the roadmap, the strategic plan inherits the volatility of the detail beneath it and needs constant rework.

Product prioritization and product discovery

Product discovery generates and tests the evidence that product prioritization consumes. Discovery tells you whether a problem is real and whether a solution works. Prioritization decides which problems are worth the discovery effort in the first place. The relationship runs in both directions and never stops.

Table comparing product prioritization with estimation, backlog grooming, and roadmapping in ProdPad Product Management software

Choosing a prioritization model, and knowing when to ignore it. Different models suit different decisions, and none of them survive contact with a badly framed problem. Our breakdown covers which models earn their keep and where each one falls over.

Read: Which prioritization model is best for my product?

What inputs feed a product prioritization decision?

Whatever model a team uses, the underlying inputs are consistent. Understanding them separately makes it easier to see why two people looking at the same backlog reach different conclusions: they are usually weighting different inputs, not disagreeing about facts.

Evidence that the problem is real

The starting point is whether the problem exists at the size claimed. This comes from customer feedback management, usage data, support volume, sales objections, and churn analysis. A feature request counts as a signal about a problem rather than an instruction to build a solution, and treating it as the latter is how roadmaps fill with work nobody can justify six months later.

Strategic fit

An item can solve a real problem and still be wrong to build, if it pulls the product away from where the business is going. Strategic fit measures the item against the product strategy and the objectives already committed to. This input is the reason objective-level prioritization has to happen first.

Effort, feasibility, and appetite

Cost matters, but the useful version of this input is comparative rather than precise. Knowing that one option takes roughly a week and another takes roughly a quarter changes the decision. Knowing whether it takes eleven or thirteen days usually does not. Technical feasibility and existing technical debt belong in this input too, since both change what a given piece of work actually costs.

Confidence

Confidence records how much the team actually knows. High-impact work with low confidence is a candidate for discovery rather than commitment. Making confidence explicit is what allows a roadmap to hold both validated work and open bets without pretending they carry equal certainty.

Timing and the cost of delay

Some work loses value if it happens later, and some does not. Contract renewal cycles, compliance deadlines, competitive windows, and seasonal demand all attach a clock to a decision. The Cost of Delay approach exists to make that clock visible. As the practitioners at Black Swan Farming put it, cost of delay combines urgency and value, two things people routinely conflate when arguing about priorities.

Opportunity cost and dependencies

Every commitment forecloses alternatives, and the alternative foregone is part of the decision. Dependencies compound this: work that unblocks three other initiatives carries value beyond its own impact. Sunk cost belongs in the opposite column, since money already spent is not a reason to keep spending.

None of these inputs resolves cleanly into a number, and the ones that do are usually the least reliable. The value of naming them is that a team can identify which input is actually in dispute when a prioritization conversation stalls.

Where do prioritization frameworks fit into product prioritization?

Frameworks are instruments for organizing the inputs above. They structure a conversation and make reasoning visible to people who were not in the room. They do not make the decision, and no framework compensates for prioritizing at the wrong level.

Scoring models such as RICE, ICE, and Weighted Scoring produce a comparable number across items. Categorization models such as MoSCoW and the Eisenhower Matrix sort items into buckets rather than ranking them. Customer-centered models such as the Kano Model and Opportunity Scoring weight satisfaction and unmet need. Economic models such as Weighted Shortest Job First build timing into the calculation. Collaborative methods such as Buy-a-Feature and Affinity Grouping surface stakeholder reasoning rather than producing a ranking at all.

Each of these has a shape of decision it suits and a shape it distorts. The full comparison, including where each one breaks, is covered in The Product Manager’s Guide to Prioritization Frameworks.

See why a flat backlog makes scoring models produce the wrong answer

How does product prioritization work in practice?

The mechanics vary by organization size and product maturity, but the working pattern is fairly consistent across teams that do it well.

Who takes part

Problem-level product prioritization is owned by Product, informed by Engineering on feasibility, by Sales and Customer Success on commercial signal, and by Design on user impact. Executive input belongs at the objective and portfolio levels rather than in individual item ranking. Larger organizations formalize this through a product council, which gives senior stakeholders a scheduled forum and reduces the incentive to lobby Product Managers individually.

How often it happens

Portfolio decisions move annually. Objective decisions move quarterly. Problem-level decisions get reviewed monthly or when significant new evidence lands. Idea-level decisions move continuously as discovery produces results. Sequencing happens every sprint. Running all of these on the same cadence is a common structural mistake, and it usually results in either strategic churn or delivery paralysis.

What a prioritization cycle looks like

Consider a B2B SaaS company selling into financial services with a twelve-person product team. The objective for the quarter is reducing time-to-value for new enterprise accounts, chosen over expanding integrations. That single objective decision removes roughly half the backlog from contention immediately.

Within that objective, four problems compete: slow data migration during onboarding, unclear permission configuration, missing audit trail visibility, and a fragmented admin experience. Product weighs feedback volume, deal-cycle impact from Sales, and support ticket concentration, and puts migration and permissions in Now, audit trail in Next, and admin experience in Later where the assumptions still need testing.

Only at that point do ideas get scored. For data migration, the options are a self-serve import tool, a white-glove migration service, and a template library. Effort and confidence differ sharply across the three, and a scoring model earns its keep here because the options are genuinely comparable. The team runs the template library first as the cheapest way to learn whether the underlying problem is format complexity or process confusion.

Product prioritization decision recorded against a roadmap initiative in ProdPad Product Management software

What are the most common product prioritization anti-patterns?

The failure modes below are structural. They emerge from how the work is organized and what the tooling encourages, rather than from any individual making poor calls.

Prioritizing only at the idea level

The most widespread pattern. The team has a long list of proposed solutions and ranks them against each other, without ever asking which problems deserve attention. The output is a defensible-looking order built inside an undefended frame. Everything on the list might be a reasonable idea and the collection still fails to move any outcome.

Treating the score as the decision

A scoring model converts several estimates into one number, and the number inherits every weakness of its inputs. When a team treats the resulting rank as an answer rather than a prompt for discussion, it has outsourced judgment to arithmetic performed on guesses. The score is a structured way of surfacing where people disagree.

Running product prioritization inside a delivery tool

Delivery tools are built to track committed work through to completion. Their data model assumes items are already decided. Using one as the home for product prioritization flattens problems, ideas, and tasks into a single list of tickets, which is precisely the condition that makes prioritization impossible. Our walkthrough of product backlog examples covers the version most teams will recognize: hundreds of items accumulated in a delivery tool, the majority of which will never be built, functioning as a wish heap rather than something anyone can make a decision from.

Relitigating decisions that were already made

When the reasoning behind a decision is not written down, the decision has no durability. Anyone who disagrees can reopen it by simply asking again, and the team burns its capacity re-arguing settled questions. This is often diagnosed as a prioritization problem when it is a documentation problem.

Prioritizing once and treating the list as fixed

A prioritized backlog that has not changed in four months is either a sign of remarkable strategic stability or a sign that nobody is feeding new evidence back in. The second is more common. Priorities that never move suggest the team has stopped learning anything that would move them.

See why weak prioritization is often a decision confidence problem

How do you know your product prioritization is working?

Healthy product prioritization is easier to detect through organizational behavior than through the state of any particular list.

Stakeholders can explain the priorities without the Product Manager present. When a Sales lead can tell a customer why their request sits in Later and what would move it, the reasoning has genuinely propagated. When every question routes back to Product, the decision exists but the reasoning did not travel with it.

Declined items stay declined. A decision that holds for a quarter without being reopened, unless new evidence arrives, indicates the reasoning was strong enough and visible enough to survive. Frequent reversals in the absence of new information point to decisions made without a durable rationale.

The roadmap holds its shape while the details churn. Problem-level priorities should be relatively stable across a quarter while the ideas underneath them change constantly as discovery produces answers. The inverse pattern, stable ideas and shifting problems, means the team is committed to solutions before it has agreed on what it is solving.

Disagreement gets specific. In a functioning system, arguments are about a particular input: whether the reach estimate is right, whether the deadline is real, whether the problem is as widespread as claimed. Vague disagreement about whether something “feels important” usually means the inputs were never made explicit.

Why product prioritization falls apart without a decision record

Product prioritization is a decision-making practice, and decisions decay when their reasoning is not preserved. Most teams have adequate information and reasonable judgment. What they lack is a durable place where the decision, the evidence behind it, and the conditions for revisiting it live together, connected to the customer feedback that prompted it and the objective it serves.

That gap is why prioritization feels perpetually unfinished in so many organizations. The work of deciding gets done repeatedly because the output of deciding evaporates. Each new stakeholder, each reorg, each quarter starts the argument again from the top, and the accumulated reasoning of the last two years exists only in the memories of whoever happened to be in the room.

ProdPad was built around this problem. Ideas and initiatives carry their linked customer feedback, their impact and effort scoring, and their connection to objectives and roadmap outcomes, so a priority is never just a position in a list. It is a decision with its evidence attached, visible to anyone who wants to understand it. Delivery work still flows to Jira or Azure DevOps when it is ready to be built, and the reasoning stays where the next person can find it.

Give every prioritization decision a home, with its reasoning attached

Enjoy a single source of truth for every product idea

Start a free trial and see how easy your Product Management life could be with ProdPad
